Charlotte Concrete ContractorServing the Queen City MetroDriveways, Patios, Foundations
Local Concrete Charlotte is the best concrete contractor Charlotte NC. Check out our Charlotte Concrete Contractor Reviews we have over 300+ 5 star reviews. From residential driveways and stamped patios through commercial slabs and structural foundations, every pour uses high-strength fiber-reinforced concrete on a compacted base with structural rebar.

Pay on Completion
You take zero financial risk on residential work. If we don't pour your concrete, you don't pay us — period.
We never ask for money upfront — not for materials, not for permits, not for anything.
No payment milestones during the job. You pay one time, after the work is done.
Your driveway, patio, or slab has to be in the ground and finished before you owe a dime.
Charlotte Concrete Contractor Services
Get driveway quotes in Charlotte, patio quotes in Charlotte, or stamped concrete quotes in Charlotte — free written estimate back in 24 hours. Every pour is backed by high-strength concrete and commercial-grade reinforcement.
Charlotte-Metro Homeowners on Record
"Over 7 companies couldn't do the job and could not handle the scope of work, but they could and did an amazing job."
"They did it spot on! That was absolutely perfect to the specifications."
"Right from the beginning they answered my questions. It was an amazing experience."
Concrete Contractor Construction Portfolio
See the transformation. Drag the slider to reveal the restoration precision of our commercial and residential projects.

Finishing Touches in Motion
Watch our crew bring precision and artistry to the final stages of a premium concrete installation.



Driveway
Full residential replacement



Driveway
Driveway revamp



Stamped Pool Deck
Total demolition and replace



Patio Replacement
Old slab out, new finished slab in



Stamped Concrete Landing
Custom stamped finish + edge tie-in



Driveway Replacement
Tear out + fresh pour
How a Charlotte Pour Actually Runs
Site walk, subgrade compaction to the local code, rebar layout drawn against Mecklenburg County setbacks, pour scheduled around the humidity window, finish troweled to your spec, joints cut before the concrete sets, seal on day 28. Nothing skipped, no unlabeled crew.
Charlotte-Specific Questions We Actually Hear
Permit questions from Matthews homeowners, tree-protection questions from Weddington, HOA finish-spec questions from SouthPark. Answered without runaround below.
Ask a QuestionWhat ballpark should I expect for a NC driveway pour in 2026?
Every NC pour is priced against the actual site — dimensions, tear-out volume, subgrade condition, and access all move the number. Rather than quote a generic per-square-foot rate that won't hold up, we walk your property, measure everything, and email back a fixed all-in written price within a business day. That number stays flat unless you change scope. And you don't pay a cent of it until the concrete is finished.
When can I actually park on new concrete in NC?
In the Charlotte metro, foot traffic is fine at the 48-hour mark and daily passenger cars at day 7. Anything heavier — a full-size truck, an RV, a moving van, or a boat trailer coming back from Lake Norman — should wait the full 28 days for the mix to reach design strength. Piedmont summer humidity slows the cure a bit compared to what national guides suggest, which is why we always default to the conservative window here.
Do stamped patios get slippery in the NC rain?
The stamp texture itself creates a micro-profile the water can't sit on cleanly — think of it like fine slate rather than polished stone. For pool decks or covered porches where extra grip matters, we blend a fine grit additive into the sealer coat at no additional charge. It's an add we volunteer on any shaded NC outdoor living area.
Are cracks unavoidable on a NC slab?
Charlotte's red clay soil expands and contracts more than most people realize, and every slab responds to that movement. What we control is WHERE that movement releases: we saw-cut control joints within 4-8 hours of finishing so the natural shrinkage cracks form at the joint line, not across the middle of your driveway. Combined with 4000 PSI mix and #4 rebar on 18-inch centers, we push visible field cracking off for decades — but any contractor claiming a lifetime crack-free pour is selling you something.

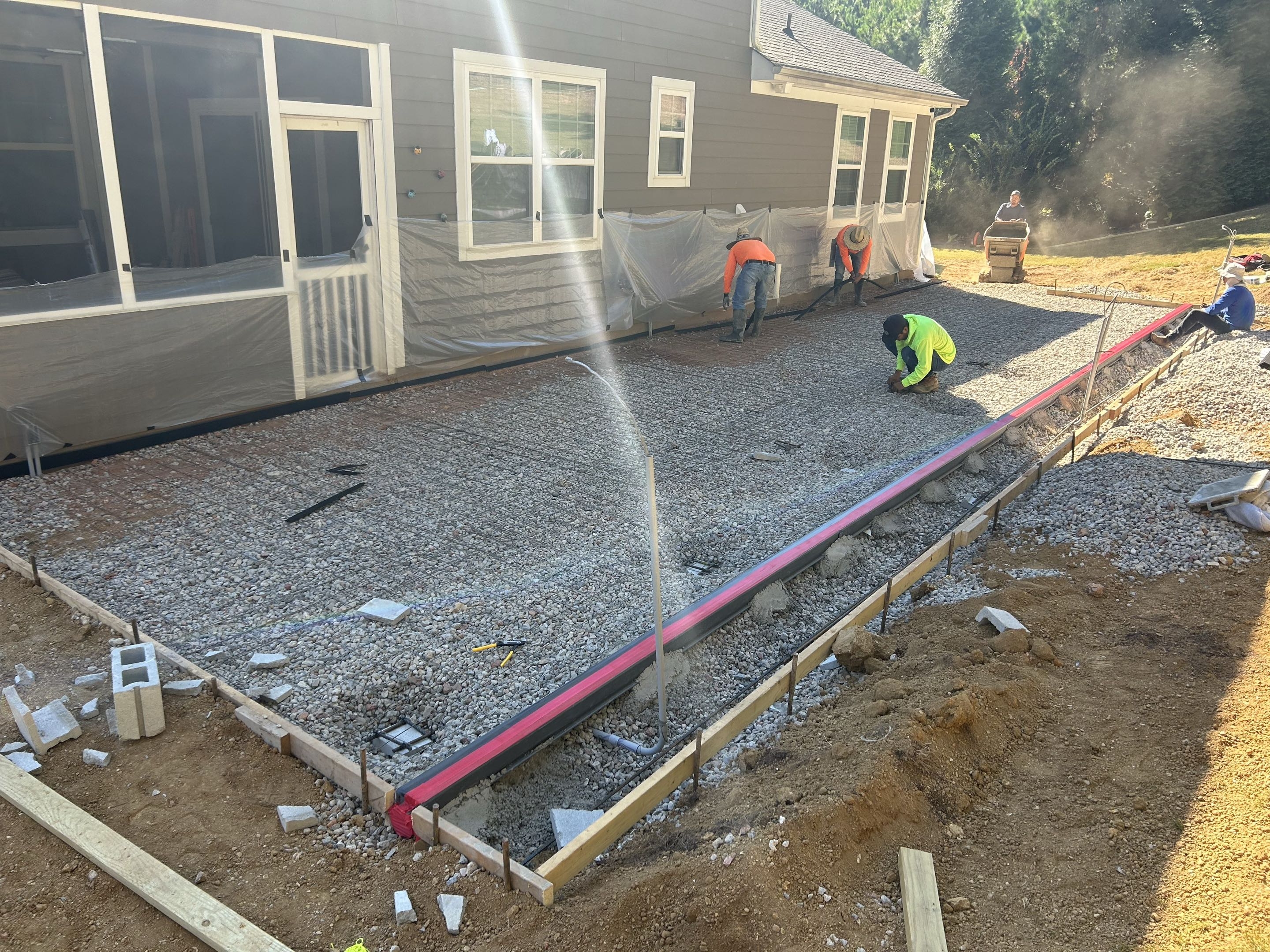

Is rebar really necessary for a residential NC driveway?
On our jobs, yes — every single one. Wire mesh technically qualifies on some regional specs but it slumps to the bottom of the slab during the pour and does almost nothing structurally. Real #4 rebar tied at 18-inch centers stays in the middle of the slab and locks the concrete together if the Mecklenburg County clay swells hard in a wet spring. The material cost delta is under 5% of the job; the structural payoff is 10x.
How thick should the slab actually be at my NC address?
4 inches handles daily cars and SUVs — that's the residential default in the Queen City. Bump to 5 inches if you park a Ford Super Duty, F-350, or a dually. 6 inches for RVs, boats-on-trailers, or anything regularly rolling in over 10,000 lbs. Detached-garage slabs and workshop pads get sized to whatever equipment you plan to store on them. We don't over-spec, but we also don't shave thickness to lower the bid.
Can we just pour over the cracked slab already in the NC driveway?
We advise against it every time in the Charlotte market. Reflective cracking will telegraph every existing crack up through the new pour inside 18 months, because the underlying movement hasn't stopped. Overlay pours also raise the driveway grade, which turns your garage into a low spot in a Piedmont thunderstorm. Tear-out plus a properly graded gravel base costs 20-30% more day one and lasts three decades longer — that's the honest math.
Do I need to seal the new concrete around my NC home?
Broom-finish driveways in the Charlotte metro don't need sealing to survive — a properly-mixed 4000 PSI pour with air entrainment stands on its own. Sealing is worth it in two specific cases: stamped or colored work (protects the design), and any pour under a heavy tree canopy where tannin drip and algae are chronic problems. We'll flag both scenarios on the estimate, not up-sell you into a coat you don't need.
What's the realistic lifespan of a Charlotte-area driveway pour?
Done to our standard — 4000 PSI mix, 4-inch compacted #57 stone base, structural rebar, joints cut on time, air-entrained mix for Piedmont freeze-thaw — a Charlotte driveway will hold up 30 to 50 years with almost no attention. Failures we replace are almost always three problems in combination: skipped base prep, no rebar (or wire mesh only), and joints cut late or not at all. We refuse all three shortcuts.
Do you handle Mecklenburg County / Union County / Cabarrus permits?
Yes. Charlotte-Mecklenburg BSD handles most of our permit filings; jobs in Weddington, Waxhaw, Matthews, and Mint Hill route to their own town planning offices; Union County covers the unincorporated addresses; and Cabarrus handles Harrisburg + Concord. We know the intake window at each and file the paperwork the same day you sign. Impervious surface cap, tree protection, and driveway apron encroachment permits are all included in the quoted scope.
Why do you spec high-strength mix on every NC residential slab?
The national residential minimum is 3000 PSI. We pour 4000 PSI on driveways and structural slabs in Charlotte because the per-yard cost delta is trivial — around $8-12 per yard — and the density improvement makes the slab noticeably more freeze-thaw resistant across Piedmont winters. It also cuts surface abrasion under daily vehicle traffic. On foot-only walkways we drop to 3500 PSI. Never below.
What happens if it rains during a NC pour?
Light Piedmont mist we power through — surface water at that intensity actually helps the finish. Real thunderstorms we tarp the slab immediately (poly sheeting stays in every truck for exactly this) and re-finish the surface once the front passes. If a cell is forecast to hit inside the placement window, we push the pour to the next dry morning. The concrete goes down right, not on schedule.
Does new concrete actually add NC home value?
A cracked, patched, or gravel driveway is the single fastest deferred-maintenance flag a Charlotte-area buyer reads on a home tour. Replacing with a clean flat pour drives the perceived home condition up a notch instantly — and stamped rear patios add usable square footage that Mecklenburg County appraisers now credit toward outdoor living space. Recovery on resale is typically 60-80% of the concrete spend, plus you enjoy it while you own the house.
How does drainage get designed on NC sites?
Before we form up, we shoot grades across the whole area with a laser level. Slab surface gets sloped 1/8-inch to 1/4-inch per foot away from any structure, and the compacted base under it is graded to match. When the natural site slope fights us — common on Charlotte's rolling lots — we spec a trench drain at the low edge or route a French drain to daylight. Drainage failures cause more cracking here than any other single factor.
What causes surface flaking, and how do you prevent it on NC slabs?
Spalling — the surface flaking off in thin chips — is almost always cold-weather damage: water absorbed into the pores freezes and pops the top layer off. Two prevention tactics we bake into every NC pour: an air-entrained mix (microscopic bubbles absorb the freeze expansion) and a slightly denser trowel finish that closes surface porosity. And one hard homeowner rule: never put rock salt on new concrete for at least the first winter. Calcium chloride or plain sand only.
How many days should I plan for a typical NC project?
A standard Charlotte-metro driveway or patio runs one to three working days. Day one covers demo, base prep, form-set, rebar tie, pour, finish, and joint saw-cutting. Day two pulls forms and cleans up. Day three, when needed, hauls the tear-out debris. Multi-section pours or decorative work stretch the schedule. Rain and cold snaps push the start date but never change the sequence — we don't rush a pour just because we said Tuesday.
